Allens Creek ReservoirAn Independent Texas Water Project Resource
Austin County, Texas • Lower Brazos River Basin
A Lake Decades in the Making
Just north of Wallis, beside one of the most powerful rivers in Texas,
a project first imagined more than half a century ago is again moving
toward reality.
Allens Creek Reservoir could become one of the most consequential water
projects in this part of Texas. Its story involves abandoned nuclear
power plans, explosive regional growth, drought, groundwater, the Brazos
River and a question that matters enormously to nearby communities:
what happens when the river floods?
Independent project overview • Updated November 13, 2026
Current Status
Allens Creek Reservoir is in the engineering, environmental study and
federal permitting phase. Major construction has not begun. On November 10,
2026, the Brazos River Authority approved a new professional services
contract with Lockwood, Andrews & Newman, Inc. BRA reports that the
project is on schedule and under budget. Field investigations continue.
The May 2026 engineering work plan runs through August 2027, and regional
water planning still identifies 2040 as the implementation decade.
[9][3][4]
Following the project
Latest Project News & Updates
Allens Creek Reservoir Advances: New Engineering Contract, Field Studies and Financing Plans
The Brazos River Authority (BRA) is moving forward with Allens Creek
Reservoir north of Wallis in Austin County. At its November 10 Board
meeting, BRA approved a professional services contract with Lockwood,
Andrews & Newman, Inc. (LAN), adding to the technical work already
underway. BRA program manager Rachel Lane reported that the project
remains on schedule and under budget. That is a report on progress
to date, not a guarantee of the eventual construction cost.
Engineering is moving from maps to the field
GFT Infrastructure's technical team has completed the boundary survey
of BRA's land, brought the topographic survey up to date and carried
out initial soil investigations. Crews have also been examining
environmental and cultural resources and potential floodplain effects,
while meeting with local leaders. This work builds on the engineering
program authorized in May 2026.
Why the Lower Brazos needs storage
The reservoir is expected to deliver nearly 100,000 acre-feet of
dependable water supply per year, which BRA estimates could serve
approximately 400,000 families. Its location is important: roughly
9,000 square miles of the basin drain toward the lower river without
a major upstream reservoir controlling runoff from that area. With
off-channel storage, BRA could retain water during suitable river
flows and supply downstream customers when needed. The reservoir
would not require a dam across the Brazos itself.
The federal permitting case is taking shape
BRA already has the land and state water rights. The next major
regulatory hurdle is the federal Clean Water Act Section 404 permit.
HDR Engineering is helping BRA document the need for the project,
including existing supplies, historical use, requests for long-term
water contracts and forecasts of future demand. An earlier estimate
of about 150,000 acre-feet of additional demand in the lower basin
is being revisited. The federal permit has not yet been secured.
State financing could reduce borrowing costs
BRA plans to seek $50 million through the Texas Water Development
Board's State Water Implementation Fund for Texas (SWIFT). Deferred
loan financing could save up to $15 million in interest relative to
comparable market borrowing. The authority sought financing last
year without receiving an award. The new request is not an approved
loan, and the savings are an estimate. BRA continues to plan for
the project through its own rate-supported financing.
What this means for Wallis, Simonton and nearby communities
The active floodplain investigation is particularly important for
residents along the Brazos. The announcement does not provide study
results or establish whether the project will change flooding at
particular properties or communities. Nor does it announce the
start of construction or a new completion date. The existing 2040
planning horizon remains just that: a planning assumption.
Read our discussion of local flood concerns.
Drive State Highway 36 south from Sealy toward Wallis and the countryside
still looks unmistakably rural Texas. Farm fields stretch toward the horizon.
Cattle graze. Allens Creek winds through low country toward the Brazos River.
Nothing from the highway announces that thousands of acres here have been
assembled for a lake that could one day cover roughly 7,000 acres.
Yet that is the plan. The Brazos River Authority owns approximately
9,559 acres between Highway 36 and the Brazos River, north of Wallis
and south of Sealy. Much of the property remains under interim farming
and grazing leases while the reservoir works its way through years of
engineering and permitting.
[1]
If ultimately built, Allens Creek Reservoir would not simply add another
blue shape to a Texas highway map. It would become a major storage component
in the Lower Brazos water system at a time when Fort Bend County, Brazoria
County and the greater Houston region continue to add people, businesses
and industrial demand.
Not a Dam Across the Brazos
The first thing to understand about Allens Creek Reservoir is what it is
not. No one plans to build a giant dam across the Brazos River
at Wallis.
Allens Creek is planned as an off-channel, pumped-storage reservoir.
An earthen embankment would impound Allens Creek and the surrounding
reservoir basin beside the Brazos. When river flows are sufficiently
high and water is legally available, pumps would move water from the
Brazos into the reservoir. That water could remain in storage until
drought, population demand or system operations make it valuable later.
[1][4]
In simple terms
Think of the reservoir as a very large savings account for water.
The Brazos River delivers water unevenly. At times there is more
water passing downstream than can be put to beneficial use. During
drought, the opposite can be true. Allens Creek is intended to capture
some legally available water during wetter periods and store it for
the future.
Brazos River adequate flow
→
Pump Station moves water
→
Allens Creek stores water

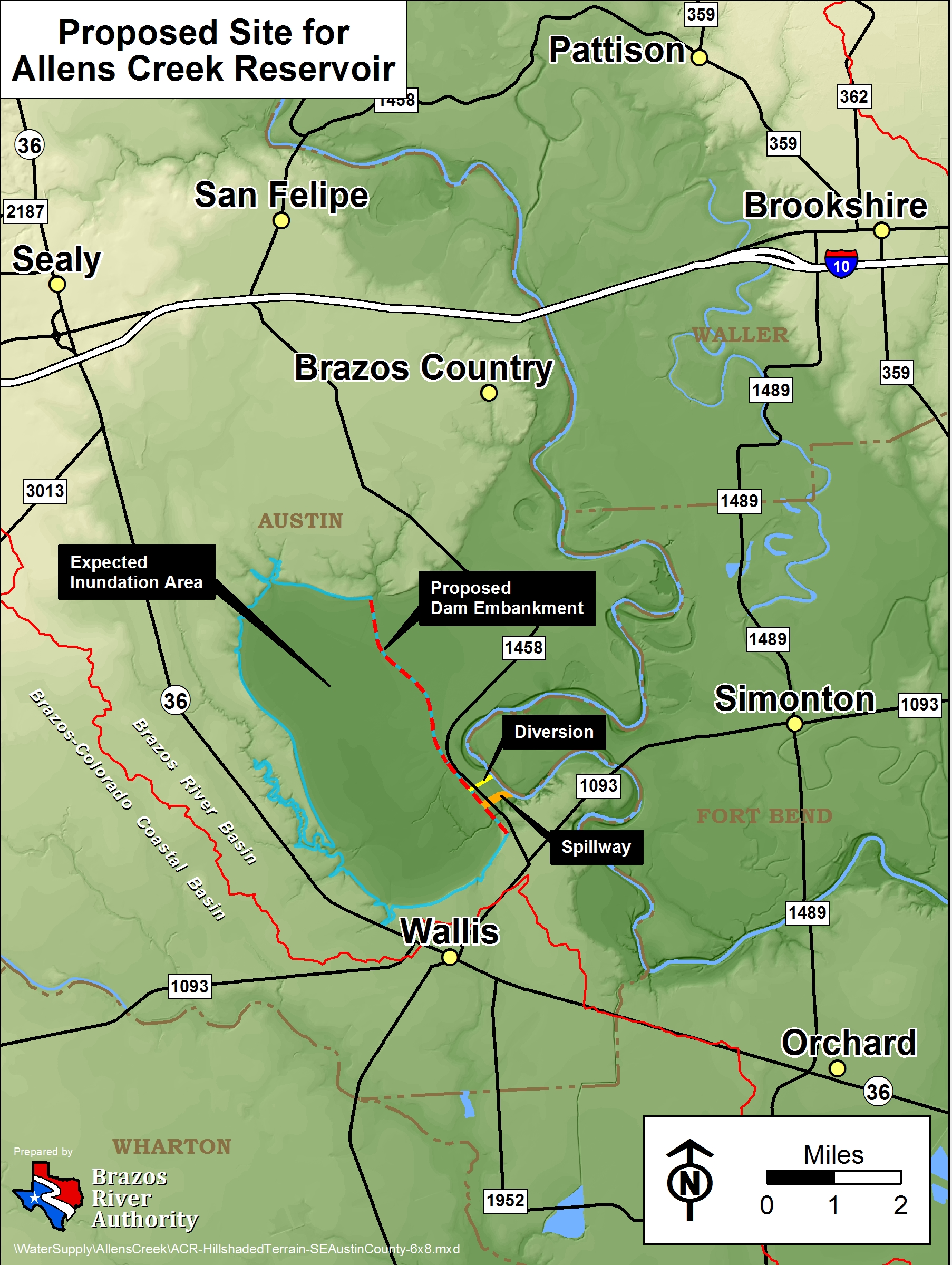

Proposed Allens Creek Reservoir site showing the expected inundation area,
proposed embankment, diversion area and spillway in relation to Wallis,
Simonton, Sealy and the Brazos River.
Map credit: Brazos River Authority.
The Project by the Numbers
~7,000Acres of proposed reservoir surface
145,333Acre-feet of authorized storage
99,650Acre-feet per year of projected firm supply
~20 ft.Approximate average depth
~40 ft.Approximate depth near the dam
4.25 mi.Approximate embankment length in current planning
2,200 cfsMaximum authorized Brazos diversion rate
2040Current regional-plan implementation decade
Figures are based on current BRA materials and the adopted 2026 Region H
Regional Water Plan and remain subject to refinement during design and permitting.
History
A Reservoir Born From a Power Plant That Was Never Built
The origins of Allens Creek Reservoir reach back to 1974, when Houston
Lighting & Power received a water-right permit for a reservoir that
would supply cooling water to a proposed nuclear power plant. The plant
was never built. The nuclear project disappeared, and the original
reservoir permit eventually expired.
[1]
The location, however, did not stop making sense as a place to store water.
Texas lawmakers later created a path for the project to return as a water
supply reservoir. In 2000 the Brazos River Authority and City of Houston
acquired the property, with financing participation by the Texas Water
Development Board.
At the time, Houston was expected to need most of the future reservoir's
supply. The arrangement generally contemplated Houston taking the larger
share and BRA the smaller. But water planning changed. Houston developed
other supply options while demand continued to grow elsewhere in the
Brazos Basin, particularly in Fort Bend and Brazoria counties.
[1]
In May 2022, BRA acquired the remaining interests and became the sole
owner and developer of the reservoir project. That change was more than
paperwork. A project that had spent years in something close to suspended
animation finally had one owner with a direct reason to move it forward.
1974
A water-right permit is issued for a reservoir intended to supply
cooling water for a proposed nuclear power plant.
1980s
The nuclear project is abandoned. The original reservoir permit
eventually expires.
2000
BRA and the City of Houston acquire the Allens Creek property.
The reservoir re-emerges as a future regional water-supply project.
May 2022
BRA purchases the remaining project interests and becomes the
sole owner and developer.
December 2024
TCEQ amends Water Use Permit No. 2925B, moving the state deadline
to commence construction to September 1, 2035.
2025
Environmental, geotechnical, cultural-resource and other field
investigations advance as BRA prepares the project for federal permitting.
May 2026
BRA authorizes a professional-services engineering contract with
GFT Infrastructure and an initial work plan of up to $18,811,652
through August 2027.
[3]
November 2026
BRA approves a professional services contract with Lockwood,
Andrews & Newman, reports progress on schedule and under budget,
and continues field investigations and federal permit preparation.
[9]
Around 2040
The adopted 2026 Region H Water Plan identifies 2040 as the
implementation decade for the reservoir. This is a planning
assumption, not a guaranteed opening date.
[4]
Why Build It Now?
Water projects are rarely built for the population that exists on the
day construction begins. They are built for the population expected
decades later.
The Lower Brazos Basin is no longer the mostly rural region it was when
Allens Creek was first contemplated. Fort Bend County has become one of
the largest and fastest-growing suburban counties in Texas. Industrial
and municipal demand continues downstream toward Brazoria County and
the Gulf Coast. At the same time, parts of the region face pressure to
reduce reliance on groundwater because excessive groundwater withdrawal
contributes to land subsidence.
[2]
A new reservoir in the lower basin gives BRA something especially useful:
storage close to growing demand. Instead of relying only on water stored
hundreds of miles upstream, the system would be able to capture water
from the lower Brazos during favorable river conditions and hold it near
the customers that may eventually need it.
“The real value of Allens Creek is not simply that it creates a lake.
It creates time, allowing water available during wet periods
to be saved for the dry ones.”
How Much Will It Cost?
There is not yet a final construction price, and anyone presenting one
as settled is getting ahead of the engineering.
BRA currently describes the total project cost as roughly
$700 million, with the estimate expected to become more
precise as federal permitting and design advance. Meanwhile, the technical
analysis in the adopted 2026 Region H Water Plan lists a capital cost of
approximately $493.9 million in September 2023 dollars.
Those numbers are not necessarily contradictory. They reflect different
planning assumptions, dates and levels of project development.
[1][4]
The important point is simpler: Allens Creek is a project measured in
hundreds of millions of dollars, and its eventual cost will depend on
final engineering, mitigation requirements, materials, construction
markets, financing and the years that pass before major construction begins.
November 2026: A new financing opportunity
BRA plans to apply for $50 million in SWIFT deferred-loan financing
through the Texas Water Development Board. The estimated interest
savings could reach $15 million compared with similar open-market debt.
BRA says its rate planning already assumes it can fund the reservoir
without state or federal assistance. The financing is being pursued,
not yet awarded, and does not establish a new total project cost.
[9]
The Permit That Matters Most
BRA already owns the land and holds the state water rights needed for
the project. The great remaining regulatory hurdle is the federal
Clean Water Act Section 404 process administered through the U.S. Army
Corps of Engineers.
That process is why construction cannot simply begin because a conceptual
dam line exists on a map. Engineers and environmental specialists must
evaluate wetlands, streams, wildlife, cultural resources, archeological
sites, cemeteries, alternatives, drainage, flood behavior and other
potential impacts. Where adverse impacts cannot be avoided, mitigation
may be required.
[1]
In November 2026, BRA reported completed property boundary mapping,
updated topography and initial soil exploration. Its consultants are
also developing the federal purpose-and-need case, updating estimates
of future water demand and considering existing supply alternatives.
This work informs the permit application; it does not constitute federal
approval. [9]
BRA estimates the permitting and design phase could require approximately
five to ten years, followed by another four to seven years of construction.
That is why 2040 is a more useful planning horizon than any promise of an
exact opening day.

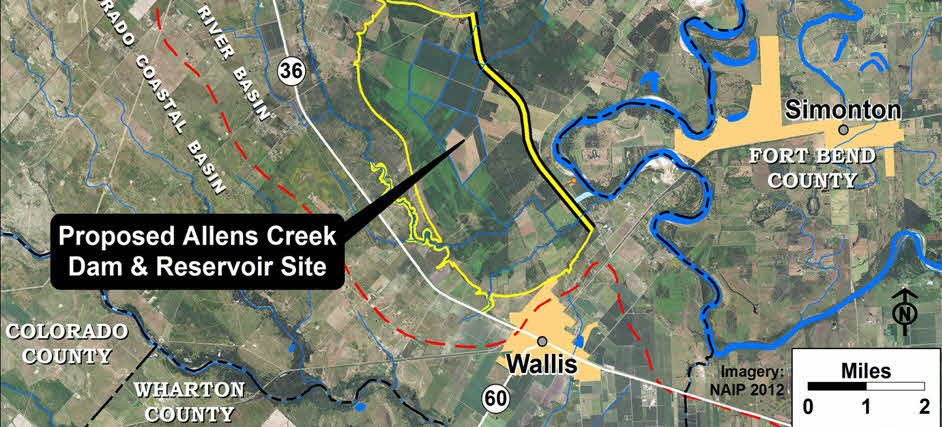

Aerial view of the proposed Allens Creek Reservoir and dam area in relation
to Wallis, Simonton, State Highway 36 and the Brazos River.
Image credit: Brazos River Authority.
The Question Locals Ask First
What About Flooding?
For people who live along this part of the Brazos, nearly every
discussion about a new 7,000-acre reservoir eventually reaches the
same subject.
Flooding here is not theoretical.
Simonton, Wallis and the surrounding Brazos bottomlands occupy a
landscape shaped by the river. The Brazos has left its banks repeatedly,
spreading across roads, fields and communities that may appear a
considerable distance from the ordinary river channel.
The City of Simonton's own comprehensive planning documents describe
major Brazos River flood events in 2015, 2016 and 2017. In May 2016,
roughly 250 homes in Simonton were affected and mandatory evacuations
were required in some areas. During Hurricane Harvey in August 2017,
the city's plan reports that approximately 80 percent of Simonton
flooded.
[5]
Those memories matter because the proposed reservoir property sits
immediately beside the Brazos and because the dam embankment would
become a major new man-made feature in an already complicated
floodplain environment.
November 2026 update: BRA confirms that field teams
have been examining floodplain impacts at the proposed reservoir site.
No conclusions about flood depths, flow paths or property-level risks
in Wallis, Simonton or surrounding communities were announced.
[9]
Allens Creek Reservoir is not being designed as a
flood-control reservoir.
BRA states this explicitly. Unlike a reservoir built primarily
for flood control, Allens Creek's principal purpose is water
supply. Its storage is intended to hold usable water rather than
maintain a large empty flood pool waiting for the next storm.
[1]
Could the reservoir make flooding worse?
That is one of the questions the permitting and engineering process
is required to answer.
BRA says studies must evaluate the project's potential effect on
flooding and that if the reservoir would negatively affect flooding,
those impacts must be mitigated or avoided. That could mean engineering
changes, drainage modifications or changes in project configuration
depending on what detailed hydraulic modeling ultimately shows.
[1]
The concern is understandable. A miles-long embankment placed in a
low-lying river environment inevitably raises questions about where
floodwater would go, whether existing drainage paths would change,
how water moves around the structure during extreme events and what
happens at the spillway and outlet works. Those are engineering
questions, not questions that can responsibly be answered by looking
at a project map alone.
Could the reservoir actually help?
Possibly, in limited circumstances, but that should not be confused
with calling Allens Creek a flood-control project.
Because the reservoir will pump water from the Brazos when river
flows are adequate and because its design necessarily interacts
with local drainage, future engineering could conceivably produce
localized drainage benefits or allow some water to be captured at
favorable times. BRA's own FAQ specifically acknowledges questions
about whether flooding and drainage problems around Sealy and Wallis
could be addressed in connection with the project.
BRA's present answer is appropriately cautious: detailed flood studies
around the proposed site are part of the engineering and permitting
phase. Until those studies are completed and publicly available,
claims that the reservoir will either solve regional flooding or
worsen it should be treated as unproven.
[1]
What happens when the Brazos itself is in flood?
The reservoir's pumps do not mean BRA will indiscriminately pump
floodwater into the lake whenever the river rises. Diversions remain
governed by the project's water rights, environmental requirements,
operating rules, reservoir capacity and the physical limitations
of the intake and pumping system.
The reservoir will also receive some natural inflow from the Allens
Creek watershed. Its spillway and outlet system therefore must be
engineered to safely manage water entering the reservoir as well as
releases from it.
For nearby residents, the most important future documents may not
be glossy renderings of the lake at all. They will be the hydraulic
models, flood-impact studies, drainage plans and final engineering
drawings produced during permitting. Those documents will tell the
community far more about local flood consequences than conceptual
maps can tell us today.
Bottom line: flooding is a legitimate local
concern, the reservoir is not a flood-control reservoir, and the
final answer about its effect on surrounding flood behavior will
depend on engineering studies that are still part of the ongoing
permitting process.
Life on the Future Lake
Will People Be Able to Boat and Fish Here?
Formally, BRA's current answer is that recreation may be allowed,
with a final determination expected after the federal Section 404 process.
That cautious language is important because the project has not yet
completed permitting or final design.
[1]
The broader record, however, makes the likely direction fairly clear.
BRA has repeatedly discussed recreational opportunities at Allens Creek.
Earlier project announcements stated that recreation would be allowed,
although potentially on a limited basis because lake levels could fluctuate.
BRA has also publicly said it is committed to making recreational
opportunities available and has discussed possibilities including boating,
fishing and public access.
[7]
The likely question is not simply “recreation or no recreation?”
The more useful questions are likely to be: How much public access?
Where will the boat ramps and parks be? Will camping be offered?
How much shoreline will be accessible? And how will fluctuating
water levels affect boating and fishing during drought?
BRA's existing water-supply reservoirs, Possum Kingdom Lake, Lake Granbury
and Lake Limestone, all support public recreation. Parks, boat ramps,
fishing, boating and other uses coexist with their primary water-supply
purpose.
[8]
Allens Creek would likely differ from the image many people have of a
constant-level suburban lake. Water stored here is meant to be used.
During extended drought or heavy water demand, the shoreline could move
substantially as reservoir levels fall. BRA specifically cautions that
water levels may fluctuate significantly.
That does not make recreation unimportant. A new lake of this size in
Austin County would almost inevitably attract anglers, boaters, wildlife
watchers and visitors. It could also affect nearby land use and economic
activity in ways that are impossible to fully predict years before the
first boat ramp is designed.
What Happens Next?
The phrase “proposed reservoir” can make a project sound hypothetical.
Allens Creek is further along than that phrase sometimes suggests.
BRA already owns the property. It already holds the state water right.
Millions of dollars are now being spent on engineering, environmental
work and federal permitting. The 2026 BRA engineering authorization
represents active project development rather than merely a line item
in a distant water plan. The November contract and ongoing field studies
are additional steps in that process. Follow the
latest project updates as the work advances.
[3][9]
Yet there is also a long distance between an active project and a finished
lake. Federal authorization must be secured. Flood and environmental
impacts must be studied. Final engineering must be completed. Financing
must keep pace with the project. Construction itself could take years,
followed by the process of filling a reservoir whose water can only be
captured when legal and hydrologic conditions permit.
In other words, Allens Creek is neither a fantasy nor a lake that will
appear next summer.
It is a major Texas infrastructure project slowly moving from paper,
permits and soil borings toward something much more visible. For the
people of Wallis, Simonton, Sealy and the communities of the Lower Brazos,
that makes the next several years worth watching.
Questions & Answers
Allens Creek Reservoir FAQ
The questions most likely to matter to residents, property owners,
visitors and anyone following the project.
Where exactly will Allens Creek Reservoir be located?
The project is in Austin County, north of Wallis and south of Sealy,
between State Highway 36 on the west and the Brazos River on the east.
The Brazos River Authority owns approximately 9,559 acres associated
with the project.
Is the reservoir in Wallis or Simonton?
The reservoir site itself is primarily in Austin County immediately
north of Wallis. Simonton is east of the Brazos River in Fort Bend
County and is close enough that residents understandably follow the
project closely, particularly because of flooding and regional
development concerns.
Has construction started?
No. As of November 13, 2026, the project is in engineering, environmental
study and federal permitting. Field investigations and preliminary
project work are underway, but major reservoir construction has not begun.
What is the latest news on Allens Creek Reservoir?
On November 10, 2026, BRA approved a new professional services contract
with LAN. BRA reports the project is on schedule and under budget,
with boundary surveying completed and other fieldwork ongoing. BRA
also plans to seek $50 million in SWIFT financing. See the
November 13 project update for details.
[9]
Is Allens Creek Reservoir definitely going to be built?
No large infrastructure project should be described as absolutely
certain before permits, financing and final design are complete.
However, BRA owns the site, controls the project, possesses the state
water right and is actively spending millions of dollars on engineering
and permitting. Allens Creek is therefore an active development project,
not merely a speculative lake shown on an old map.
When could construction begin?
Construction cannot begin until required permitting and studies are
sufficiently complete. BRA estimates approximately five to ten years
for permitting and design, although the actual schedule can change.
When could the reservoir be finished?
The adopted 2026 Region H Water Plan uses 2040 as the project's
implementation decade. BRA estimates construction itself could take
roughly four to seven years. “Around 2040” is therefore a useful
planning horizon, not a guaranteed completion date.
Is there a deadline for BRA to begin construction?
Yes. TCEQ amended Water Use Permit No. 2925B in December 2024.
The amended order requires construction to commence by
September 1, 2035.
How large will Allens Creek Reservoir be?
Current regional planning describes a reservoir surface of approximately
7,000 acres with authorized storage of approximately 145,333 acre-feet.
Final dimensions can still be refined through design and permitting.
How deep will the lake be?
BRA currently estimates an average depth of about 20 feet, with water
approximately 40 feet deep near the dam.
How long will the dam be?
The 2026 Region H project analysis describes an earthen embankment
approximately 4.25 miles long.
Will the Brazos River itself be dammed?
No. Allens Creek is an off-channel reservoir. Water will be pumped
from the Brazos into the reservoir when river flows and water rights
allow. The main Brazos River channel will not be blocked by the
Allens Creek dam.
Where will the water come from?
Most stored water is expected to be pumped from the Brazos River.
A smaller amount will enter naturally from the Allens Creek watershed.
How much water can BRA divert from the Brazos?
The current permit authorizes diversion of up to 202,000 acre-feet
per year from the Brazos River into the reservoir at a maximum
diversion rate of 2,200 cubic feet per second, subject to applicable
permit conditions, environmental requirements and senior water rights.
How much dependable water supply will the reservoir create?
The current planning estimate is 99,650 acre-feet per year of firm
water supply, approximately 89 million gallons per day when expressed
as an average annual rate.
Why not simply pump water directly from the Brazos when it is needed?
Because the river does not always have abundant legally available
water at the same time customers need it. Reservoir storage allows
water available during wetter periods to be saved for drought and
high-demand periods.
Who owns Allens Creek Reservoir?
The Brazos River Authority is now the sole owner and project developer.
BRA acquired the remaining interests in 2022.
Didn't the City of Houston used to own most of it?
Yes. The earlier project structure anticipated Houston receiving the
larger share of the reservoir's water supply. Houston's long-range
needs changed, and BRA ultimately acquired the remaining project
interests in May 2022.
Why was a reservoir first planned here?
The original 1970s plan was to provide cooling water for a proposed
nuclear power plant. The power plant was abandoned, but the location
later returned to Texas water planning as a regional water-supply site.
How much will the reservoir cost?
BRA currently gives a rough total estimate of about $700 million.
The adopted 2026 Region H technical analysis lists approximately
$493.9 million in September 2023 dollars. The eventual project cost
will be refined as design and permitting progress.
Is Allens Creek Reservoir a flood-control reservoir?
No. Its primary purpose is water supply. It is not designed with a
dedicated flood-control pool in the way many U.S. Army Corps of
Engineers flood-control reservoirs are operated.
Could the reservoir increase flooding in Wallis or Simonton?
That is precisely the type of issue the engineering and permitting
process must evaluate. BRA says potential flood impacts must be
studied and any negative flooding impacts must be mitigated or avoided.
Detailed hydraulic results will be more meaningful than speculation
before those studies are complete. BRA confirmed ongoing floodplain
investigations in November 2026, but did not release findings about
flooding in either community.
Could Allens Creek Reservoir reduce flooding?
Possibly in some localized circumstances, but flood reduction is not
the project's stated primary purpose and no broad flood-control benefit
should presently be assumed. BRA has acknowledged questions about
whether local drainage problems could be improved in connection with
the project, but detailed flood studies are part of the ongoing
engineering and permitting work.
Why are Simonton residents especially concerned about flooding?
Simonton has experienced repeated Brazos River flooding. City planning
documents identify major events in 2015, 2016 and 2017. Approximately
250 homes were affected during the May 2016 flood, and the city's
comprehensive plan reports that about 80 percent of Simonton flooded
during Hurricane Harvey in August 2017.
What happens if the Brazos is already flooding?
Reservoir operations will be governed by water-right conditions,
river conditions, environmental requirements, available reservoir
capacity and operating procedures. The project is not intended to
function as an uncontrolled floodwater diversion basin.
Will Allens Creek still flow into the Brazos?
Yes. BRA's current design concept includes a spillway that will allow
Allens Creek flows to continue toward the Brazos River.
Will the lake be open to fishing?
A final recreational-use decision has not yet been formally made.
However, BRA has repeatedly discussed fishing and other public
recreational opportunities at the future reservoir and has said it
intends to make recreational opportunities available.
Will boats be allowed?
Boating appears likely based on BRA's prior public statements and
operation of its other water-supply lakes, but the final access plan,
regulations and facilities have not yet been established.
Will there be boat ramps, parks or camping?
Those details have not been finalized. BRA has publicly discussed
recreational access and has said it is committed to making recreational
opportunities available. The location and extent of parks, ramps and
other facilities will come later in the design process.
Will Allens Creek be a constant-level lake?
No. It is a working water-supply reservoir. Levels are expected to
fluctuate as water is stored and released, especially during drought
and periods of heavy demand.
Could homes eventually be built along the shoreline?
No large-scale private shoreline development plan has been announced.
Much of the reservoir perimeter is part of BRA's project property,
and final shoreline configuration, public-use areas and operational
restrictions will depend on project design. Assumptions about future
waterfront subdivisions would therefore be premature.
Will nearby property values increase?
A large recreational lake can influence nearby land use and property
demand, but Allens Creek is years from completion and the extent of
future recreation and public access is still being determined.
Property-value predictions today would be speculative and highly
dependent on location, flood risk, access, land-use changes and the
final reservoir design.
What is currently on the reservoir property?
Much of the property remains in agricultural use while the project
proceeds through permitting. BRA reports thousands of acres under
interim farming and grazing leases.
Are there cemeteries or archeological sites in the project area?
Yes. BRA states that previous studies identified archeological
resources and that documented and undocumented cemeteries may be
affected. Additional cultural-resource investigations are required.
Some cemeteries could ultimately require relocation under formal
procedures before construction.
What environmental permits are required?
The project involves multiple state and federal requirements.
The most prominent remaining process is the federal Clean Water Act
Section 404 authorization involving the U.S. Army Corps of Engineers.
Other agencies may be involved in environmental, wildlife, water
quality and cultural-resource review.
Can the public participate in the process?
Yes. BRA has stated that public involvement will be part of the
permitting process. Formal federal and state proceedings may also
create opportunities for notices, comments and public review as the
project advances.
Why is the name sometimes written “Allen's Creek”?
Historical references occasionally use an apostrophe, but the official
contemporary project name used by the Brazos River Authority and
Texas water-planning documents is generally Allens Creek Reservoir.
Where can I find official project information?
The Brazos River Authority maintains the primary project page and FAQ.
The Texas Water Development Board's Region H planning documents provide
detailed technical and water-supply information. Links to those official
resources are provided in the Sources section below.
Research
Primary Sources & Further Reading
This page is independently published. Project facts have been compiled
primarily from public records and materials produced by the Brazos River
Authority, Texas Water Development Board, City of Simonton and U.S.
Geological Survey. Project specifications and schedules may change as
engineering and permitting continue.
Brazos River Authority:
Allens Creek Reservoir Frequently Asked Questions.
View official BRA FAQ
Brazos River Authority:
May 2026 project update and Board action approving the GFT Infrastructure
engineering contract and initial work plan.
Read project update
Supplementary source: Brazos River Authority Board of Directors:
May 13, 2026 Board actions.
View Board actions
Brazos River Authority:
Public statements concerning recreation and future recreational opportunities
at Allens Creek Reservoir.
Read BRA public Q&A
Brazos River Authority:
Information about BRA reservoirs, water-supply operations and recreation.
View BRA reservoir information
Supplementary source: U.S. Geological Survey:
Brazos River monitoring station at Richmond, Texas, including long-term
river and peak-flow records.
View USGS river data
Brazos River Authority:
November 13, 2026, Moving forward with a new reservoir, improving another two.
Reports November 10 Board action, engineering and fieldwork, permitting
preparation and planned SWIFT financing.
Read the November 2026 announcement
Editor's note: Older maps, presentations and articles
about Allens Creek Reservoir may contain outdated ownership percentages,
cost estimates, reservoir dimensions or schedules. Where newer information
is available, this page gives preference to current BRA materials and the
adopted 2026 Region H Regional Water Plan.
About the Publisher
Johnny Quarles
AllensCreekReservoir.com is published by Johnny Quarles, a Texas
Real Estate Broker/Agent and owner of Katy-Fulshear Real Estate.
Johnny works throughout Fulshear, Simonton, Wallis, Weston Lakes,
Katy and surrounding communities in western Fort Bend County and
the greater west Houston area.
Major infrastructure projects can influence communities long before
construction is complete. New roads, water projects, flood-control
improvements, development patterns and regional growth can all become
part of the larger real estate picture. This site was created as an
independent resource for people who want to understand one of the
most significant long-term projects proposed for this area.
